Skip to content

The Capacity view

A grid of builders down the side and weeks across the top. Each cell is one builder’s week.

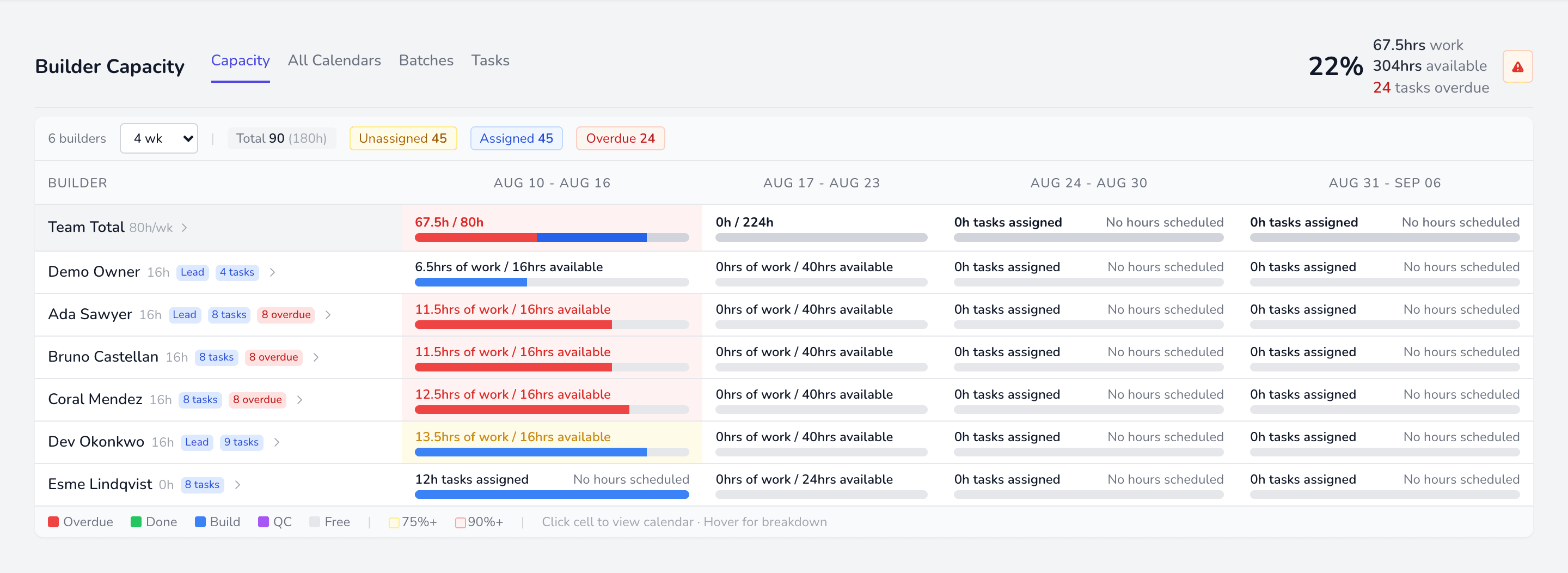

The Capacity view, showing builders against four weeks with utilisation bars

Each cell shows hours booked against hours available, with a bar broken into segments:

Colour Segment
Red Overdue — should already be done
Green Completed
Blue Still to build
Amber Stopped — owed, but waiting on somebody
Purple QC time

Amber is carved out of the blue rather than added beside it: stopped work is still owed, it just cannot be picked up as things stand.

Build hours leave the bar when the build finishes, not when the task does. A task waiting on its QC check keeps its QC hours and drops its build hours, because nobody has to build it again.

The bar is proportional to that builder’s available hours, so a bar running to the end means fully booked.

A banner above the grid reports how much of the open work is fully crewed, split three ways:

Need a builder Nobody is on it at all
Need a QC person A builder is set, but the task needs QC and no checker is named
Ready Fully crewed

The two gaps are counted separately because they need different actions, and each chip filters Tasks down to exactly that set. A per-builder need QC person badge shows the same thing for work someone already holds — they cannot finish those as they stand.

A separate row, pinned at the top, for work that is late and belongs to nobody. It is the first thing to clear: it counts against no builder, so it is easy to miss.

Click a cell to jump to that builder’s week in All Calendars. The overdue and no date pills on each row jump to Tasks, filtered to exactly those tasks.
