Getting an order's work scheduled

Creating an order does not schedule it. Two separate things have to happen.

Each line item generates tasks from its product’s task template. No template, no tasks — this is the usual reason a brand-new order looks empty.

A task counts as scheduled once it has both a build date and a builder. Until then it sits in Capacity Planner under Unscheduled Tasks with a blank Scheduled column.

  1. Open Capacity Planner and go to the Tasks tab.

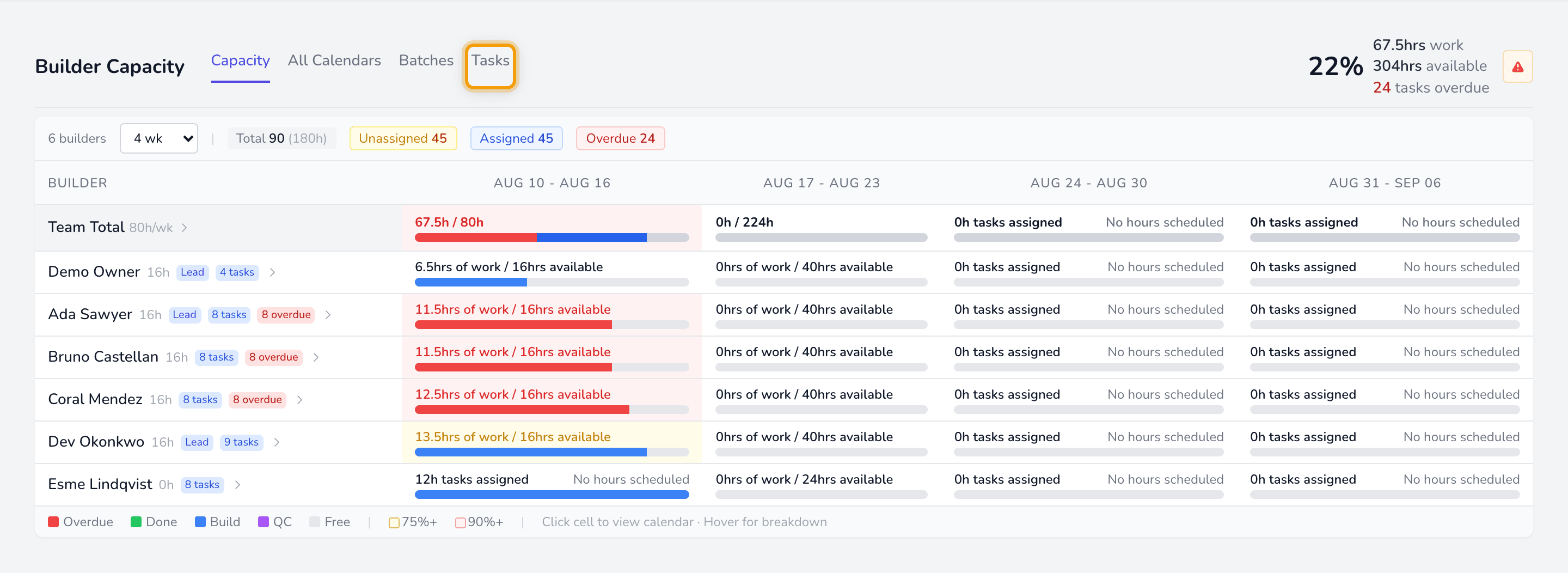

    The Capacity Planner with the Tasks tab highlighted

  2. Filter to Unscheduled Tasks. This narrows the list to work that has no build date — the backlog you are trying to clear.

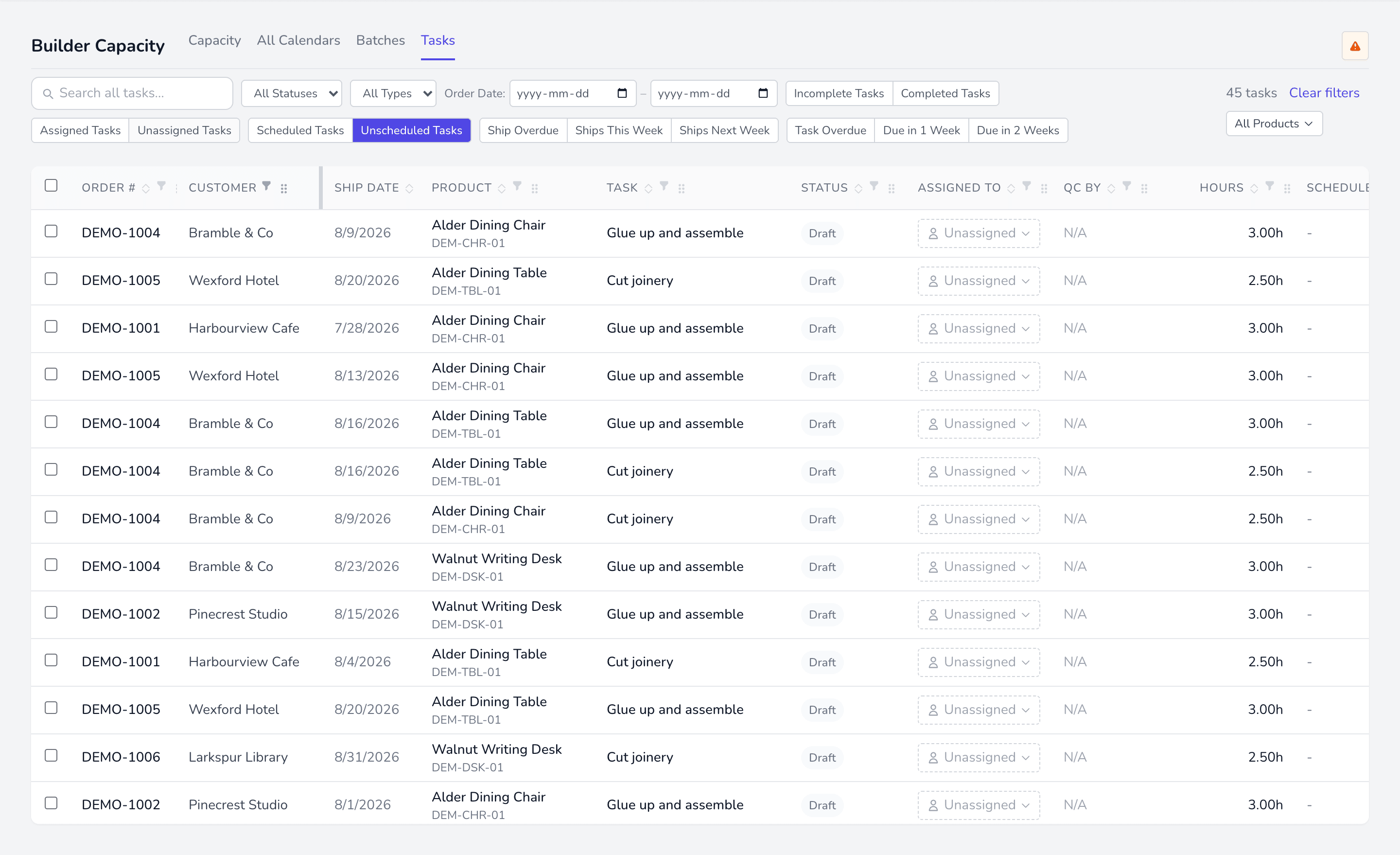

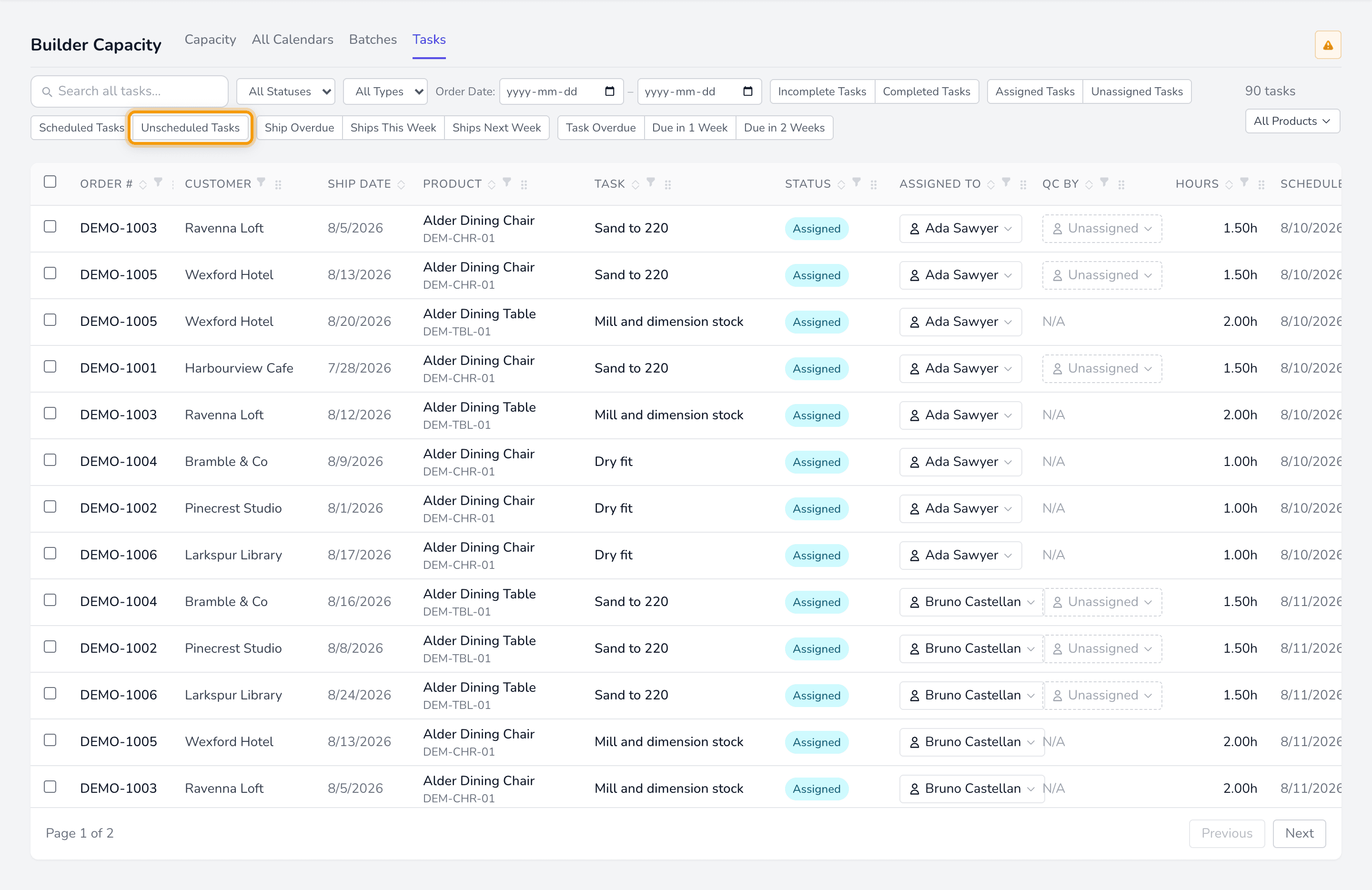

    The Tasks view with the Unscheduled Tasks filter highlighted

  3. Check the Scheduled column is blank. Every row now shows an empty Scheduled cell, which is what “unscheduled” means. If a date appears here, the filter is not applied.

    The task list filtered to unscheduled work, Scheduled column empty

  4. Assign a builder from the Assigned To column. Only builders qualified for that task’s job are offered, so an empty list means a missing qualification rather than a missing person.

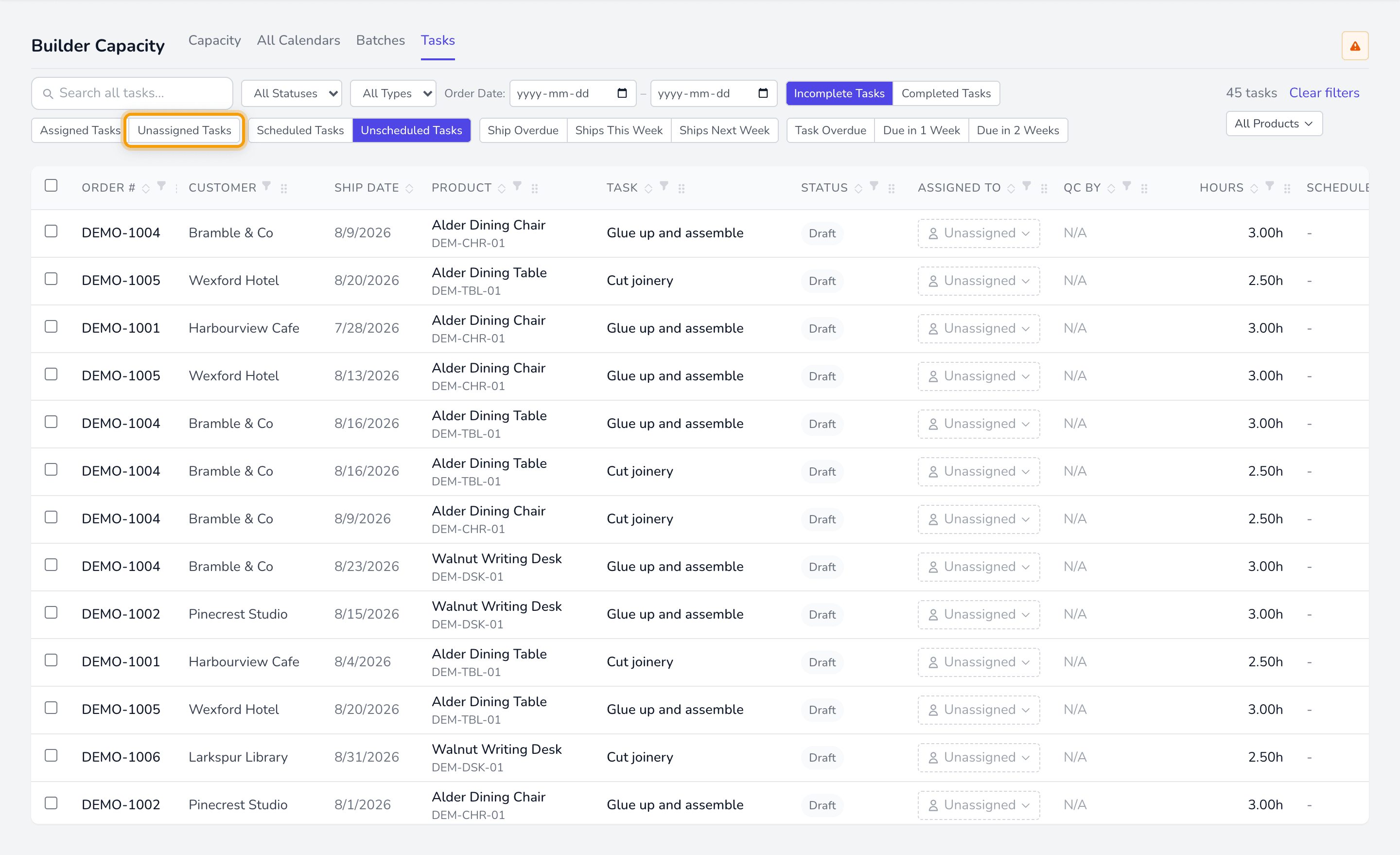

    The Assigned To picker on a task row

  5. Set the date. Assigning a builder clears any existing build date so the schedule can be recalculated for the new person — set the date after assigning, not before.

Symptom Cause
No tasks on the order The product has no task template.
Assigned To list is empty No builder is qualified for that task’s job.
Builder has no room No availability entered for that week.
Task will not sit on the calendar Its duration exceeds the availability block.
